September 26

  • 01. Milestone of the Month
    • Construction momentum continued, with the Danoa Camp completed, major plant equipment advancing into fabrication, additional construction contracts awarded, and zero lost-time or medical treatment injuries.
  • 02. Construction Progress
    • Bulk earthworks completed for the construction camp, operations village and wet-plant area.
    • Two additional production boreholes completed with headworks, bringing the total to three on-site production boreholes.
    • Process plant earthworks continued, with completion targeted for October.
    • Substation and laydown-area earthworks progressed, paving the way for electrical and concrete contractor mobilisation.
  • 03. Major Equipment and Procurement
    • Transport & Logistics, Steelwork and Platework contracts awarded.
    • Bolted CIL tanks, SAG/Ball mills and thickeners advanced into fabrication.
    • Key mechanical packages awarded, including vibrating screens, electrowinning cells and water-treatment plants.
    • EPCM/Supply progress running ahead of schedule.
    • Internal local procurement committee established, with 145 local suppliers registered in the local vendor database.
  • 04. Workforce & Recruitment
    • Workforce climbed to 622 people, with 163,282 hours recorded.
    • Earthworks contractor reached 171 on-site personnel.
    • Seven new starters in September, strengthening HR, emergency response and technical capability.
    • Project internship programme approved for launch.
  • 05. Safety
    • 500,000 LTI-free hours milestone achieved.
    • Contractor safety audit scores remained strong.
    • Corrective-action closure rate reached 84.7% across 1,082 recorded actions, supporting continuous improvement.
  • 06. Community & Environment
    • Joint site visit with National Maritime Affairs and CIAPOL to review environmental and maritime compliance.
  • 07. Next 30 Days
    • Complete Operations Village earthworks and camp handover.
    • Mobilise the concrete contractor, continue water bore drilling and award major equipment packages.
    • Complete substation bulk earthworks to enable electrical contractor site establishment.
    • First concrete pour for the process plant.

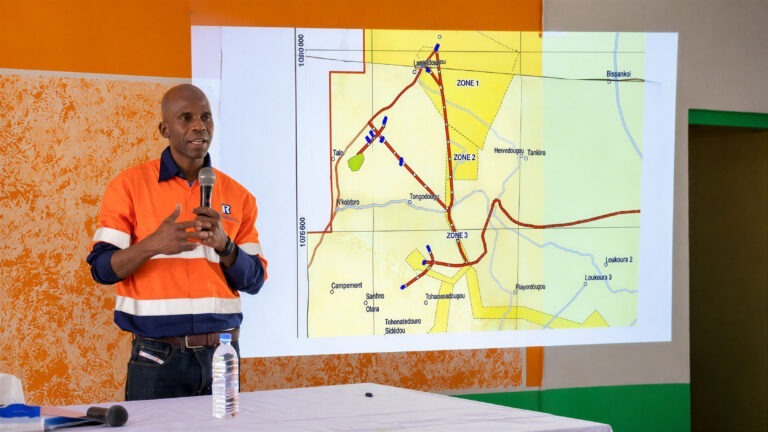

Constructing trust around Doropo

Constructing trust around Doropo

5 Oct 2026
ESG Manager Mory Diakité on listening, resolving challenges and building the relationships…

August 26

  • 01. Milestone of the Month
    • Significant progress on accommodation facilities, site infrastructure and major equipment procurement for processing plant and +60 km grid line extension.
    • Site prepared for first concrete pour in the next weeks.
  • 02. Construction Progress
    • Danoa camp expansion first accommodation units completed and undergoing commissioning with relocation of teams closer to site.
    • Water supply development – 26 boreholes drilled, additional production bore infrastructure installed.
    • Earthworks progressed across construction camp, operations village and process plant areas, including cut-to-fill activities, compaction works and site preparation.
    • +20 km local access road refurbished in anticipation of rainy season.
    • Rehabilitation of Bouna airstrip to begin charter flights to site.
  • 03. Safety
    • No lost-time injuries or medical treatment injuries during July.
    • Safety focused on training, inspections, emergency preparedness and continuous improvement.
    • Contractor safety audit scored 89%, reflecting ongoing engagement with health and safety performance.
  • 04. Major Equipment and Procurement
    • Key equipment progressed: cyclone clusters, primary jaw crusher, bolted CIL tanks, high-rate thickeners, slurry agitators and oxygen plant.
    • Contracting advanced across logistics, structural steel, platework fabrication and tank installation packages.
    • First orders of long-lead items for power grid line extension.
    • Construction camp and HDPE liner materials deliveries continued.
  • 05. Workforce & Recruitment
    • Over 550 people working on site.
    • Project contractors recruited 17 local labourers in July alone, thanks to ongoing local employment initiatives.
    • Preparation of literacy, apprenticeship and internship programmes for construction phase and operation preparedness.
  • 06. Community & Environment
    • In July, 42 stakeholder engagement meetings covered employment, procurement, community development and compensation.
    • No environmental incidents recorded.
    • Crop inventory and evaluation completed on 300 ha out of additional 1600 ha of second phase land compensation for main project development area.
  • 07. Next 30 Days
    • Finalise water bore drilling and equip 4–6 bores.
    • Receive approximately 1million2 HDPE liner for TSF and Process water ponds.
    • Complete 48 Room expansion of Danoa Camp and receive 176 rooms for the construction camp.
    • Launch of power grid line works.
    • Arrival of first equipment at Abidjan port.
    • First concrete pour.
Growing opportunity, one harvest at a time.

Growing opportunity, one harvest at a time.

3 Aug 2026
How the women of Holidouo are turning a one-hectare market garden into fresh produce for their tables.…

July 26

  • 01. Milestone of the Month
    • EPCM construction management team on site.
    • Concrete works awarded – civil works underway.
  • 02. Construction Progress
    • Earthworks contractor mobilisation – approx. 40 heavy vehicles now on site.
    • Over 20km of access roads established and 74 hectares cleared for construction camp, mine village and process plant areas.
    • Temporary Starlink-powered comms infrastructure established – internet, Wi-Fi, VHF tower, and radios, while 4G tower comes online.
  • 03. Safety
    • Zero lost-time injuries.
    • Zero medical treatment injuries since construction commenced.
    • Emergency management plan finalised.
  • 04. Procurement Activity
    • Jaw crusher, thickeners, structural steel and platework awarded.
    • HV power line and substation contracts awarded.
    • Concrete works, HDPE liner and permanent accommodation camp contracts awarded.
  • 05. Workforce & Recruitment
    • Over 120 employment opportunities advertised.
    • 22 local community members employed during June.
    • Recruitment continued to prioritise host community employment.
The people building Doropo

The people building Doropo

3 Jul 2026
Construction Manager Blake Taylor on first impressions, early progress and what it takes to turn a plan into a mine.…

June 26

  • 01. Milestone of the Month:

    Ground broken on the Process Plant, with early works and bulk earthworks advancing across key site infrastructure, including access roads and water boreholes.

  • 02. Construction Progress:
    • Danoa Camp: Kitchen and dry mess upgrades handed over; 48 additional rooms in delivery.
    • Bulk earthworks underway at Process Plant and Permanent Village.
    • Site connectivity infrastructure commissioned.
    • CIS now managing camp catering and infrastructure.
  • 03. Safety:
    • 92 days without a Lost-Time Injury (LTI) since construction commenced.
  • 04. Long Lead Items Ordered:
    • SAG and Ball Mills: in manufacture. Bolted CIL tanks ordered. HDPE liner for tailings storage facility secured.
    • Construction camp and associated facilities awarded.
    • HV long lead tenders adjudicated and recommended for award.
  • 05. Work Packages in Procurement:
    • Permanent (operations) village package awarded.
    • EP & Supply, Construction Management Services, transport & logistics progressing through tender and contract negotiation.
  • 06. Workforce:
    • 332 people currently on site.
    • 87% Ivorian nationals; 24% recruited from host communities.
    • 89% men / 11% women.
  • 07. Recruitment:
    • 14 community members hired locally.
    • 2 senior project personnel onboarded.
    • 7 further project roles confirmed.
  • 08. Community & Environment
    • Full support secured from community leaders and parliamentary representatives for access to early works areas.
  • 09. Next 30 Days:
    • Grid power contract awards expected.
    • Early works and bulk earthworks to continue progressing.
Getting started at Doropo Gold Mine

Getting started at Doropo Gold Mine

28 May 2026
Roads, water infrastructure and local recruitment mark the beginning of visible construction.…
Back to Top of the page.
